The cost of ignoring it
Capacity deficiencies are rarely apparent from routine inspection. Deferred strengthening constrains how a building can be used — floor loads, fit-outs and change of use — and emergency propping carries a substantially higher cost than planned works.
When a structure needs strengthening
Buildings are frequently required to carry loads for which they were not designed — heavier floor loads, new plant, penetrations cut through slabs, walls removed in a refit, reinforcement lost to corrosion, or defects present from construction. Carbon fibre strengthening restores or adds capacity without demolition, and in most cases without the added weight, hot works or programme that bonded steel or section enlargement would involve.
Carbon fibre laminates, wraps and strips
The system is chosen by the action the member is deficient in:

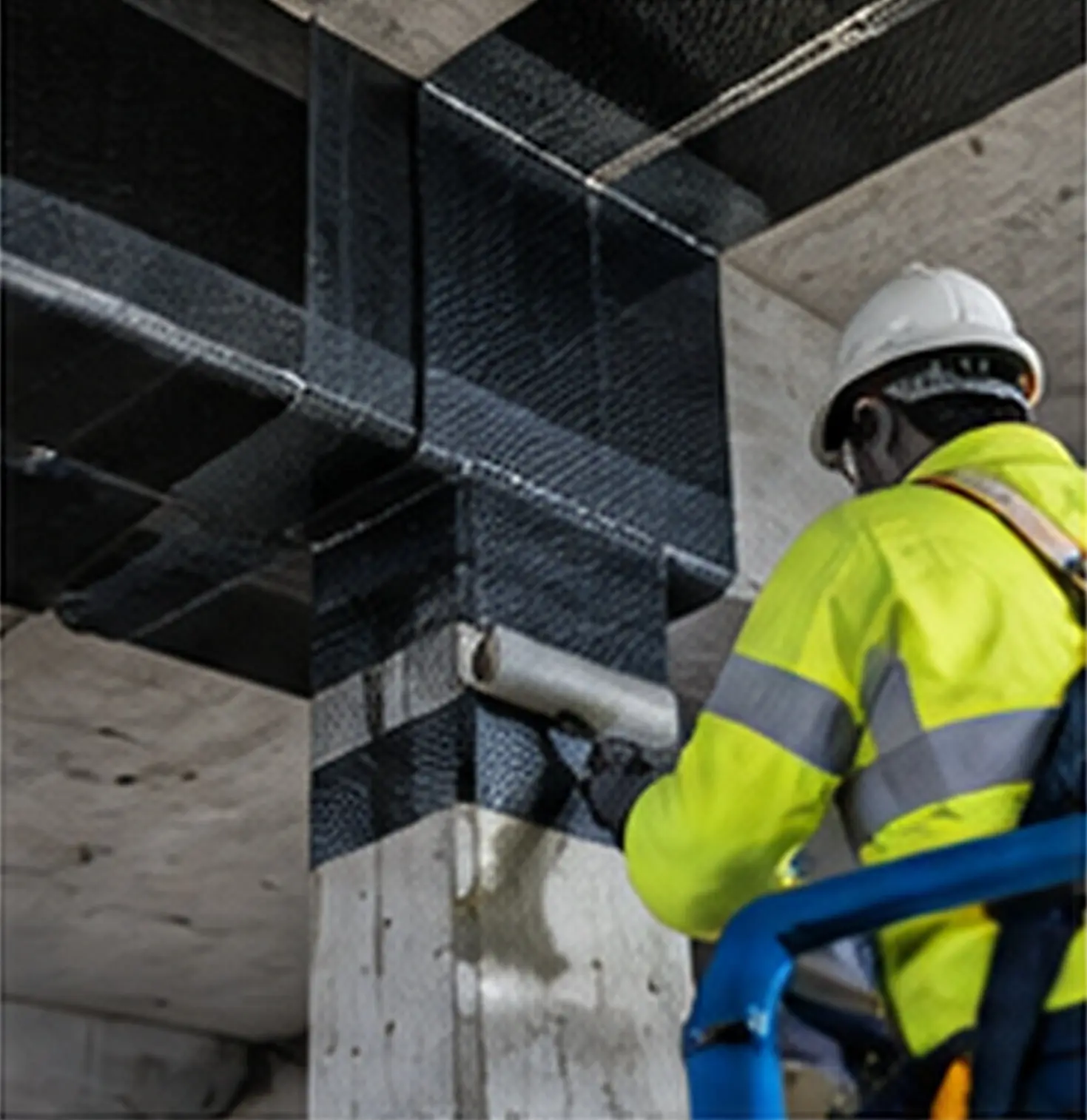

- Carbon fibre laminates are bonded to the tension face of beams and slabs to increase bending capacity. They are thin, rigid and factory-made, so their properties are consistent, and they are the most common strengthening for floors carrying new loads.
- Carbon fibre fabric wraps are saturated with resin on site and wrapped around beams to increase shear capacity, or around columns to confine the concrete and increase axial capacity.
- Near-surface mounted strips are set into slots cut into the concrete cover and bonded in with epoxy. They are used where a surface-bonded laminate would be exposed to damage, or over supports where the tension face is on top of the slab.
Laminates and wraps are designed with an anchorage length beyond the point at which they are no longer required, and often with U-wraps at the ends of a laminate to resist it peeling away from the concrete.
Diagnostic approach
Strengthening design depends on verified information about the existing structure:
- As-built verification — cover meter and GPR scanning to locate reinforcement, measure cover and confirm member sizes
- Material testing — concrete strength (cores, or rebound calibrated by cores) so that the design uses real properties
- Condition assessment — corrosion, cracking and section loss quantified before capacity is calculated, and repaired before any laminate is bonded
- Load-path review with the engineer — the visible defect is not always the member that requires strengthening
Methodology
The substrate is prepared by grinding to sound, laitance-free concrete; profile and moisture content are verified; adhesion is pull-off tested; laminates or fabrics are applied to the engineer’s layout, with the wet-out and lap requirements of the system manual; cure conditions are logged; and protective or fire-rated coatings are applied where specified.
For steel and section works, engineered temporary works are provided where required, connection details are executed as documented, and protective coating systems are selected for the design life.
Handover includes the full QA record set required for engineering certification.
Typical applications
Carbon fibre strengthening is applied to slabs supporting new plant or a change of use, to beams and columns after corrosion repair, to transfer structure upgrades, around new penetrations cut through slabs — including openings in post-tensioned slabs, see post-tensioning works — and to balcony and balustrade anchorage upgrades.
